Sweater factory capacity matters only when it connects to the buyer’s product, materials, approvals and required delivery window. A monthly output figure alone cannot show whether the required machine gauge is available, whether the selected yarn can arrive on time or whether linking and wet finishing have space for the order.
Buyers should evaluate a factory through a project-specific route. Define the sweater, ask how the factory will make it, identify the material and process constraints, then request sample and production evidence that uses the same route. The result should be a dated plan with decision gates, not a general capability presentation.
This guide is for brand and procurement teams comparing a sweater factory for a private-label order. It explains how to read gauge, construction, sampling, capacity, peak-season, MOQ, quality and delivery evidence, and it lists the questions to ask before booking. General figures help with early planning, but the buyer should still confirm every value against the current style and factory load.
What Does Sweater Factory Capacity Mean for Your PO?
Capacity is the ability to complete a defined scope within an agreed window. The scope includes more than knitting. Yarn receipt, programming, first panels, linking, washing, finishing, inspection, packing and external processes all need owners and time. A single headline number can hide the stage that actually controls delivery.
Translate headline output into a project window
Ask which machines, gauge and production route the factory proposes for the style. Then ask what work already fills the target period and when the factory will treat the order as schedulable. The factory capacity questions in the next section help buyers connect a general capability claim to the required product.
Separate theoretical output from allocated capacity. A machine may exist but stay unavailable, unsuitable for the yarn or dependent on unfinished programming. Linking, washing or inspection may also become the controlling stage even when knitting time remains free. Request a plan that shows each handoff and the responsible location.
Ask what evidence supports the proposed window. Useful evidence can include a current material check, planned machine group, approval deadline, stage dates and named external processes. Do not request confidential information unrelated to the order. Test whether the route holds together and reflects current conditions.
Define the starting conditions
A factory cannot reserve capacity against an incomplete order without conditions. List the purchase order, deposit status, approved tech pack, sample decision, yarn and color confirmation, final size chart, labels and barcode list, packaging artwork and delivery term required before production begins. The start date should refer to those inputs, not merely the date of an email.
Create a hold rule for missing inputs. For example, if the color remains open, the factory should not buy bulk yarn as though the shade had approval. If the size grade stays unresolved, programming additional sizes may create rework. The bulk production readiness guide provides a practical evidence pack for release.
Record what happens if an input arrives late. The answer may be a shifted slot, a revised sequence or a new material route. Avoid language that assumes faster production can recover every delay. A reliable plan shows the consequence before the deadline passes.
Which Sweater Factory Capacity Questions Should Buyers Ask First?
The first questions test sweater factory capacity against your calendar: sample start date, PP approval deadline, bulk start date, allocation for your style mix and shipment handover. A low quote without a production slot is only an estimate.
Ask about the bottleneck, not only the output
When a supplier quotes a number of pieces per month, ask which process currently limits your order. Depending on the style, the limiting stage may be yarn arrival, custom dye approval, programming time, 5-gauge or 12-gauge machine allocation, linking, embroidery, wash treatment, final inspection or retail packaging. Useful questions include:
- What does your production schedule look like, week by week, for the target period?
- Which gauge machines are open for my style, and how many can you assign to this order?
- Which processes stay in-house, and which may need outside support?
- What is the earliest sample start date?
- What is the earliest bulk start date after PP sample approval?
- What is the realistic ex-factory date with final inspection included?
These questions make capacity visible. They also let buyers compare unit price, MOQ, lead time, quality risk and shipping deadline together instead of one at a time.
Confirm whether the slot is firm or conditional
A production slot can be firm, tentative or only discussed. The starting conditions above usually decide which, so ask the factory which of them still lack sign-off before it treats the order as booked. Then use the following table to turn a general promise into a dated slot confirmation:
| Capacity item | What to ask | Why it matters |
|---|---|---|
| Sample start | Earliest date for the proto or fit sample | Shows whether development can begin soon enough |
| Yarn lock | Deadline to confirm composition and color | Prevents yarn purchasing or dyeing delay |
| Gauge allocation | Available machine gauge and number of machines | Confirms that the style fits the machines |
| Bulk start | First possible production week after PP approval | Turns lead time into a real calendar plan |
| Style-mix quantity | Pieces the factory can accept for this style mix | Separates total factory output from your order |
| Outside processes | Whether linking, washing, embroidery or packing stay in-house | Shows where schedule control may weaken |
| Final inspection | Inspection date before shipment | Keeps QC time from shrinking at the end |
If the factory cannot answer these points, the order may still be possible. The buyer should then add schedule buffer or reduce complexity before signing.
How Does Gauge Affect Sweater Factory Capacity?

Gauge is one part of the construction decision, so buyers should read it together with yarn count, number of ends, stitch, density, dimensions and finished hand. Two fabrics from the same nominal machine gauge can behave differently because the material and settings differ.
Start with the finished product requirement
Describe the layer, silhouette, opacity, drape, surface, weight direction and care route. Then ask the factory to propose yarn and construction inputs. The tech-pack checklist for custom knit sweaters helps the buyer state points of measure, stitch zones, ribs, seams and finishing requirements.
Request a knit-down in the proposed yarn, stitch and density before treating a machine list as evidence. Check visible loop structure, stretch, recovery, hand and opacity under the intended use. A photograph can record appearance, but it cannot prove hand, fiber composition or dimensional performance.
Avoid broad labels such as “all gauges” unless the factory explains the actual equipment and process allocation. Ask which operations remain in-house and which use a disclosed provider. The answer should match the product and the entity that accepts responsibility for changes.
Compare manufacturing routes without stereotypes
Fully fashioned panels, cut-and-sew knit fabric and whole-garment methods have different programming, seam, waste and fit implications. No route is automatically best. The right choice depends on the design, yarn, required appearance, order conditions and available equipment.
Ask the factory to mark the joining method at shoulder, armhole, side seam and neckline. Shaped panels need defined fashioning and linking requirements. For cut edges, define how the factory will stabilize and join them. Whole-garment or no-seam claims call for a sample showing that the method supports the actual silhouette and openings.
Use the sweater construction comparison to clarify development and execution responsibilities. A capability should become a written construction choice in the approved specification, not remain a sales-page description.
Check how style complexity uses capacity
Complexity can consume sweater factory capacity faster than quantity. For example, a 300-piece cardigan with six colors, custom buttons, private-label trims and retail polybags can take more management time than a 600-piece simple pullover. A chunky 3-gauge or 5-gauge style also needs different yarn feeding, panel timing and finishing control than a 12-gauge or 14-gauge knit. Mixed orders of sweaters, cardigans and vests may also compete for different machines and linking teams.
Before booking, ask the factory to break down the risk by style:
- Does the stitch structure, such as cable, pointelle, jacquard or intarsia, reduce machine speed or need special programming?
- Will the yarn need custom dyeing or special sourcing?
- Can all colors come from one yarn lot?
- Does the size range add panel programming?
- Is there a higher risk of measurement distortion after washing or steaming?
- Which details, such as crochet trims, embroidery or beading, need manual work?
- Can the same production line handle all colorways?
The right answer is more than a simple yes. A reliable supplier explains which parts are easy, which need confirmation and which may affect lead time or MOQ.

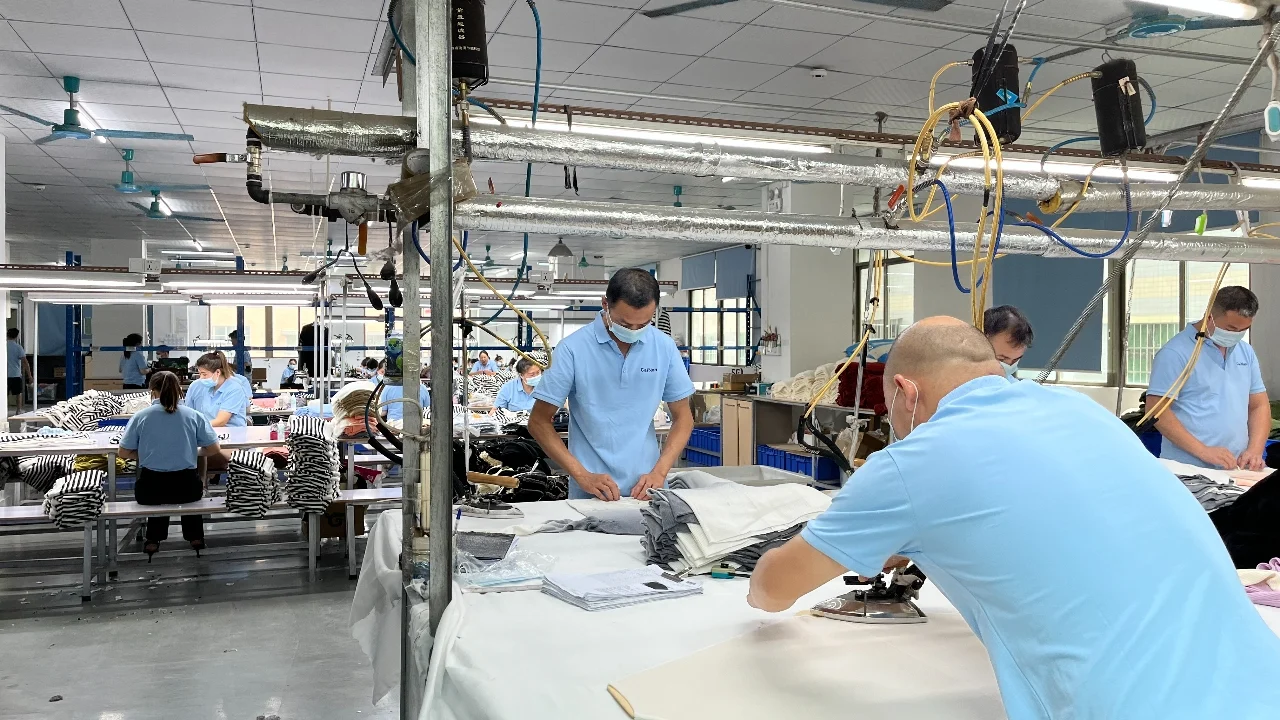

Which Sample Stages Prove Sweater Factory Capacity?

Samples answer different questions. An early prototype can confirm interpretation and silhouette, while a later pre-production or first-off garment should connect the approved design to intended bulk inputs. Calling both “the sample” makes it difficult to know which decision the buyer has actually released.
Give every sample a decision contract
For each sample, state the purpose, inputs, known substitutions and required decision. A knit-down may approve stitch direction, while a fit sample approves proportion. A size set tests grade balance, and a pre-production sample closes yarn, color, trims and packing. The fit sample and size-set comparison helps assign these decisions.
Record sample code, revision, yarn identity, color status, gauge, measurements, construction, trims and finish. Comments should name the required action and approval owner. “Looks good” is not enough to release bulk, and “make softer” is not enough to control a finishing change.
Budget pressure is not a reason to skip an unresolved high-risk decision. Reduce the number of styles entering development, simplify open variables or move the delivery date. The custom sweater sampling checklist helps close questions before they become bulk assumptions.
Separate sample capacity from bulk capacity
Sampling and bulk production use different resources. A sample technician may be free this week while suitable bulk machines stay booked for another month. The reverse also happens: machines may be available, but approval stalls because the yarn, stitch card, fit correction or lab dip remains unresolved.
At CN Sweaters, a sample usually takes 3–7 days, and bulk production usually runs 15–45 days after sample approval, depending on style and season. For OEM and ODM sweater development, ask how many sample rounds the quote includes and how long each revision takes. Also confirm the cut-off date for final comments and the latest date for PP sample approval. If the buyer keeps changing yarn composition, gauge, measurements or color standards after that date, the factory may no longer be able to protect the slot.
Connect the approved sample to bulk
Ask what will change between the approved sample and production. Sample yarn may come from available stock while bulk uses a new lot. A sample room may use different machinery or handwork. An external wash or decoration provider may enter only at production scale.
The factory should identify these differences and propose confirmation gates. The gate may be a bulk yarn approval, first panel, size set, first-off garment or wash trial. Use the sample-to-bulk stability comparison to document the route.
Keep a retained physical sample with both parties where practical, together with the written specification. The sample shows appearance and construction at one point in time. It does not replace measurements, test methods, tolerances or approved process settings.
What Must a Production Window Include?

A production window should show the sequence from complete inputs to factory readiness and shipment handoff. It must reflect current material and capacity, not a generic number copied from a capability page.
Build a stage plan with owners
List material confirmation, programming, first panels, bulk knitting, linking, wet finishing, measurements, inspection, packing and dispatch preparation. Add external decoration, testing or specialized finishing when relevant. Each stage needs a proposed window, responsible party and condition for moving forward.
The knitwear lead-time planning guide helps separate dependencies from processing time. Ask which stage is most constrained and when the buyer must approve the preceding input. A plan that names its bottleneck is more useful than one that promises a short total without conditions.
Track changes against the same schedule. When an approval or material date moves, update the affected stages and delivery forecast. Do not edit the original date without preserving the previous version and reason. This prevents the team from combining the price from one revision with the delivery promise from another.
Separate delivery milestones when assessing sweater factory capacity
Factory completion, carrier departure, import clearance and warehouse receipt are four separate milestones. Record the selected delivery term, named place and version, plus the services and costs outside it. Incoterms rules are a primary reference for delivery obligations. They do not define garment quality, payment terms or every landed-cost item.
If the factory proposes split shipments, identify how yarn lots, colors, sizes, inspection records and cartons move into each lot. Then confirm whether the later lot has protected material and capacity. A later delivery without those inputs is a new commitment, not an automatic extension.
Use the last commercially useful arrival date as a decision boundary. If the current route cannot meet it, compare a simplified product, different transport, phased launch or stopped order. The choice belongs to the buyer, who should record it before rushed production creates another risk.
When Does Peak Season Squeeze Sweater Factory Capacity?
Winter orders put the most pressure on sweater factory capacity because demand, yarn purchasing, dyeing queues and factory bookings all concentrate before fall selling windows. For a seasonal launch, even a two-week delay can affect launch timing, replenishment and the chance to sell at full price.
Plan around the seasonal calendar
Knitwear is seasonal inside the factory as well as at retail. Buyers often develop samples in spring or early summer, confirm colors in summer and need bulk shipment before fall or early winter. When many buyers approve PP samples in the same weeks, the factory must prioritize machines, yarn lots, linking teams, washing lines, inspection windows and packing space.
Our MOQ and lead time planning page lists peak season as August to January and recommends placing orders before September when possible. During that period, custom dyeing, special yarn sourcing, complex stitches and full machine schedules can stretch the usual 15–45 day bulk window. Treat capacity as a calendar asset and check it before price negotiation ends, not after every style has approval.
Secure reorders before the season fills
Reorders can be harder than first orders during peak season, since they depend on yarn continuity, machine openings and the original production standard. If the first order used a special yarn, custom color or complex stitch, a reorder may need a new yarn purchase, another dye lot, fresh shade approval and another machine setup. Even when the factory wants to support the reorder, the original slot may already be full. Before the first order ships, ask:
- Will reorder styles receive priority if sales perform well?
- Can the factory reserve yarn for possible reorders, and how long can it hold the same color lot?
- What is the minimum reorder quantity by color and size?
- Can top-selling colors run first?
- What happens if a reorder overlaps peak-season bookings?
For brands and wholesalers, late delivery is only part of the risk. The larger loss is missing the chance to replenish best-selling styles while customer demand is still active.
How Can Buyers Protect Sweater Factory Capacity Against Delay?
Discuss delay risk before the deposit, not when the shipment is already late. A clear recovery plan shows whether the factory can protect the business outcome if yarn, color approval, machines, QC or shipping fall behind.
Agree on warning points and recovery options
Every production plan has dependencies. Yarn may arrive late, lab dips may need extra rounds, a machine may move to an urgent order, or a complex stitch may need reprogramming. What matters is whether the factory reports the issue early and has a transparent way to recover. Ask these questions before booking:
- At what point will the factory warn us that the timeline is at risk?
- Can a partial shipment protect the first selling window?
- Can simpler colors or sizes run first?
- Can the factory add machines if PP approval comes late?
- Which processes can speed up without reducing QC?
- When does air freight become the only realistic recovery option?
- Who pays the extra cost if the factory, the buyer or a material supplier causes the delay?
Air freight can protect launch timing, but it changes landed cost. For sweaters, it usually makes sense only for samples, urgent capsules, partial replenishment or delay recovery when the sales value justifies the cost.
Treat an unclear window as a cost signal
A supplier with a very low price but no clear production window may create hidden costs later. Those costs can include sample waiting time, yarn delays, machine mismatch, outsourced linking, rushed QC, packaging mistakes, missed vessel dates, late store arrival, markdowns and emergency freight.
Before choosing a supplier, score each option on five points: price, MOQ, confirmed slot, QC control and shipping confidence. A slightly higher unit price may be commercially better when it comes with a realistic sample calendar, a confirmed bulk start date, suitable gauge machines, a stable yarn plan and protected inspection time. The better question is which supplier can deliver the approved product at the right quality before the selling window closes.
How Should MOQ and Cost Be Interpreted?
MOQ and capacity answer different questions. MOQ describes a minimum commercial or production commitment under stated conditions, while capacity describes what the factory can complete in a period. A low minimum does not prove the factory can deliver at the needed time, and high capacity does not prove a small order is commercially workable.
Find the constraint behind the minimum
Ask for the minimum by style, color, yarn article, size split and trim. Then determine whether it comes from material purchase, programming, production efficiency, external processing or supplier policy. The custom sweater MOQ guide provides a structured comparison.
At CN Sweaters, the garment MOQ starts from 50 pcs per color per size. Yarn and dye-house minimums are separate supplier minimums, so a custom color or special blend can still raise the total material commitment.
If the supplier proposes an available yarn or combined order, ask which input the styles share and what remains separate. Two styles on different gauges may not combine even when their colors look similar. A custom color may also create an unused yarn balance that belongs in the total commitment.
Do not carry a quoted minimum from one style to another. The current order should carry a dated material and commercial check. If the style, yarn or color split changes, reopen the minimum rather than reusing the old number in a new quotation.
Compare the full cost scope when assessing sweater factory capacity
Request material, development, sampling, programming, knitting, linking, finishing, testing, labels, packing and delivery scope. Mark inclusions, exclusions, buyer-supplied items and external charges. The sweater manufacturing cost guide helps prepare comparable RFQ inputs. The lowest price may otherwise hide missing items such as lab dips, trims, carton labeling, final inspection or urgent freight.
Use one table across shortlisted factories:
| Decision area | Evidence to compare | Clarify before approval |
|---|---|---|
| Material commitment | Yarn article, color route, purchase unit and residual balance | Availability or ownership is unclear |
| Production route | Gauge, program, linking and finish allocation | Quoted method differs from sample route |
| Sample scope | Deliverables, revisions and approval gates | Bulk starts with open decisions |
| Capacity window | Starting conditions, stages and current bottleneck | Delivery has no dated allocation |
| Quality release | References, sampling plan and decision owner | Failed findings have no closure route |
| Delivery basis | Rule, named place and included services | Prices use different endpoints |
The table makes differences visible without assuming that the lowest price or shortest total is the safest offer. Record the accepted trade-off and the person who approves it.
Which Quality Evidence Supports Release?

Quality control is a sequence of checks linked to the product and process. A final inspection alone cannot economically recover every yarn, programming, seam or finishing problem. Buyers should choose hold points where evidence can still change the outcome.
Define checks by production stage when assessing sweater factory capacity
Incoming yarn checks can confirm identity, lot and visible condition. First panels can confirm program, measurements and stitch appearance. Linking and assembly checks can find seam and trim issues, while wet-finish checks can identify dimensional and shade movement. End-of-line checks can cover completed garments, labels and packing.
Textile inspection is commonly organized across pre-production, production and delivery stages. Buyers can use these stages to organize evidence. Visual inspection still cannot prove every fiber, chemical or performance property, so laboratory testing should remain a separate controlled requirement where applicable.
Agree the lot, sampling approach, defect classes, measurement method, reference sample and release authority before production. The AQL inspection guide explains why an AQL label is incomplete without the associated plan and acceptance rules.
Keep inspection time inside the schedule
Inspection needs its own time window rather than the last day before loading. A compressed schedule can create avoidable problems:
- Loose ends, broken stitches or linking defects slip through.
- Measurement checks get rushed across sizes.
- Shade variation goes unsorted by lot.
- Care labels or hangtags end up in the wrong place.
- Carton marks and SKU counts do not match the packing list.
- Carton dimensions or weights change too late for the freight booking.
Ask to see the inspection plan before production starts, including measurement checkpoints, shade bands, the final inspection date, a carton audit and corrective-action timing. Also confirm care-label and fiber-content copy for the destination market early, so the factory does not wait for artwork or replacement labels near shipment.
Close findings with traceable action
A report should identify the inspected lot, sample, findings, affected units or batches and decision. For a failed item, record containment, cause review, corrective action and recheck. Do not accept a replacement “pass” label that cannot connect to the original finding.
Track measurements and appearance by size, color and finishing batch where the product risk requires it. Averages can conceal drift concentrated in one group. Keep photographs consistent in position and light, but do not treat them as proof of fiber content or test performance.
The OECD garment and footwear due-diligence guidance provides a framework for identifying, addressing, tracking and communicating supply-chain risks. It can structure follow-up, but it does not approve a factory, certificate or order.
How Should Buyers Approve a Sweater Factory?
Scope factory approval to the product and order. A factory may suit one gauge, construction and delivery window but not another. The decision record should show what the team has verified, what remains conditional and what would require reapproval.
Rate evidence, conditions and gaps
Classify each key item as confirmed, conditionally confirmed, proposed or missing. Confirmed evidence matches the current entity, site, product and time. Conditional evidence has a named closure item, such as bulk yarn confirmation. Proposed information remains a plan, whereas missing information has no adequate answer.
Compare legal identity, product route, material, sample-to-bulk continuity, capacity, quality release and delivery basis. The supplier comparison beyond price helps combine these areas without turning one positive signal into blanket approval.
Record rejected options and reasons. If a cheaper quote returns later, the team can check whether the factory has since closed the original gap. A price change alone is no reason to reopen approval.
Set change triggers after approval when assessing sweater factory capacity
Require a declaration for changes in production site, yarn source, article, fiber blend, machine route, stitch density, wet finishing, decoration provider, labels or packing. Reopen only the checks affected by the change. For instance, a new dye lot may need shade review; a new yarn may need identity, hand and performance checks; a new route may need another first-off and inspection plan.
Keep the final tech pack, grade, samples, material references, test and inspection records, concessions and delivery documents together. This archive supports repeat orders and makes supplier changes visible. It does not guarantee that capacity or commercial terms remain available, so refresh those items before each reorder.
Approve the factory when the evidence supports the actual order and remaining conditions have owners and deadlines. To review a specific product route, prepare the garment type, yarn direction, color and size split, sample status and delivery need, then contact the CNSweaters team with your sourcing brief.
Frequently Asked Questions
Does a high monthly output prove my order will fit?
No. Ask which gauge, machines and downstream processes the factory proposes, what it has already allocated and when your complete order becomes schedulable. Headline output does not show material availability or a project-specific slot.
How early should buyers book sweater factory capacity for winter orders?
Start capacity discussions before final PP approval, especially when the order uses custom yarn, custom colors, many sizes or private-label packaging. Peak season runs from August to January, when yarn sourcing, dyeing, machine allocation, finishing, QC and freight space can all tighten at once. Aim to place peak-season orders before September.
Which sample should be approved before bulk when assessing sweater factory capacity?
Approve the sample or set of samples that closes the actual risks. Fit, size grade, final yarn, color, trims and packing may require different evidence. Record substitutions and connect the final release to intended bulk inputs.
Can MOQ be combined across several styles?
Only when the proposed styles genuinely share the input or process that sets the minimum. Ask which yarn, color, program, gauge or finishing work can combine and which remains a separate commitment.
Why can 50 pieces and 500 pieces need a similar lead time?
Both quantities need yarn preparation, machine setup, programming, sample approval, linking, washing or steaming, pressing, inspection and packing. Larger quantities can run on more machines in parallel, while small orders still need the same setup steps. The calendar difference is often smaller than buyers expect.
What should buyers send for a capacity check?
Send the style list, tech pack or reference photos, yarn composition, gauge, stitch structure, quantity by color and size, target price, packaging plan, label files, inspection requirements, delivery date and shipping deadline. With clear inputs, the factory can check a real slot instead of giving a rough answer.
What should a capacity plan show?
It should show starting conditions, material status, main production stages, external processes, the current bottleneck, approval deadlines and delivery milestones. When something changes, the factory should issue a revised dated plan rather than overwrite the original.
Does final inspection replace inline checks when assessing sweater factory capacity?
No. Final inspection can assess a sample of completed goods, but earlier checks may cover yarn identity, first panels, linking and wet finishing. Choose hold points based on when the team can still correct a problem.
