How to Audit an August Knitwear Factory Reply

A knitwear factory reply that lists dates is not the same as a reply that holds production capacity for your order. Before you accept it, read it as a current offer with a scope, an evidence date and conditions. Then decide whether to proceed, keep a conditional option, split out a supported group or hold the affected work.

This review starts after you have chosen the styles and know the receiving requirement. It does not repeat the broad questions in our factory audit questions. It covers one narrower job: reading the supplier’s latest schedule reply and writing back a decision that matches the evidence. No fixed August deadline or output rate is assumed, because each reply has to be judged on its own facts.

Is the Knitwear Factory Reply Current and Specific?

Match the reply to the exact request

Start with the date, sender, inquiry reference and specification revision. Then confirm the style, color and size scope behind the dates. A reply written before you changed a yarn, closure or packing request may no longer describe the current order, even when the delivery line looks the same. Ask the supplier to name what was reviewed instead of assuming continuity from an unchanged email subject.

Check what each date means as well. Production completion, inspection availability and cargo handover are different events. If the reply says only “delivery,” ask which event and which place it refers to before you compare it with a warehouse date. A short duration can describe just one part of the route.

Record the unit of every time statement, because working days, calendar days and a named production week are not interchangeable. If the count starts at an approval event, name that event in the same row. For reference, our samples usually take 3–7 days and bulk usually takes 15–45 days after sample approval. The starting point is part of the promise, so the same number of days means something different when it runs from sample approval, from a deposit or from material arrival.

Separate a planning calculation from a live reservation

A scheduling tool or spreadsheet can produce a finish date without proving that anything is held. Ask what current confirmation sits behind the estimate. The reply should name the work, the readiness assumption and the person or team that owns the resource. A date calculated from material that is merely available is weaker than a dated material confirmation plus a reserved processing window.

Keep both pieces of evidence visible, and do not let a polished schedule replace the underlying answer. If you only receive a calculated date, send one follow-up: what has been reserved, for which scope and until when?

Which Resources Does the Knitwear Factory Reply Actually Hold?

Review the route at its limiting activity

Find the activity the supplier says controls completion. It might be material readiness, a knitting group, linking, finishing or another operation. Ask for enough order-specific confirmation to understand the allocation and its dependencies. Do not ask for other customers’ order details, and do not treat a photograph of busy machines as proof of capacity for your product.

Also check whether a confirmed sample slot has been presented as a bulk reservation. A supplier can be ready to answer a product question while the later production window is still open. The sweater factory capacity and sampling guide explains why development and bulk resources need separate treatment.

If the reply offers extra machines to recover time, ask which later activity changes with them. More knitting capacity does not by itself add finishing or release capacity. The peak-season capacity and price guide can help you frame the commercial questions, but it gives no price premium or output figure for your order.

Mark the evidence status of a knitwear factory reply by group

Use three review categories and write the definition of each. Confirmed means current evidence supports the named resource and conditions, not that every later event is guaranteed. Conditional means a specific input or confirmation is still open. Unavailable means the proposed route cannot support that request now, although a different offer could be reviewed separately.

The example below uses three style groups and no real quantities.

Group Example reply Review outcome Next action
A Current route and allocation identified against the reviewed revision Confirmed within stated conditions Check release authority and downstream readiness before proceeding
B Allocation offered only if a named sample issue closes before expiry Conditional Record the closing evidence, its owner and the expiry consequence
C Required finishing route not available in the proposed window Unavailable for that route Request a separately assessed alternative or hold

Do not average these rows into one confirmation. A well-supported group cannot supply missing evidence for another, and a large total order value does not remove a resource constraint.

Where documents conflict, keep the contradiction visible. A commercial reply might call group B confirmed while an attached sample note still shows its condition open. Ask the responsible owners to resolve the mismatch before you upgrade the row. Do not pick whichever attachment has the better date, and do not downgrade group A just because group B needs clarification.

Three illustrated sweater groups from a knitwear factory reply labeled Supported, Conditional and Unavailable.
Assess each group on its own evidence rather than averaging the whole program into one confirmation.

What Turns a Conditional Knitwear Factory Reply Into a Firm One?

Name the event, not a vague readiness promise

State the condition in a form anyone can observe: acceptance of a named sample revision, confirmation of a material lot, or receipt of agreed information. Then ask who decides that it has happened. Sending comments, making a request or dispatching a sample does not close a condition.

Use the records you already have. The sample delay guide helps you find the missing input, and you only need to ask for the evidence that changes the status.

In the example, fit acceptance might be the condition for group B. You need the review outcome and the supplier’s confirmation that the allocation still applies afterward. A corrected sample that arrives after the validity period cannot silently inherit the earlier route, and a request to keep an option open is not a purchase commitment.

Record expiry and the missed-condition response

Capture the exact validity date, and the time zone if the time of day matters. Ask whether the offer lapses automatically, needs renewed confirmation or carries another agreed consequence. If the reply omits expiry, record that gap and request the answer. Do not invent a default holding period from past orders.

Name who alerts whom when a condition is at risk, and which dates need revalidation. You may then revise scope, request another route or stop the affected work. Those are commercial decisions for people with the authority to make them, not automatic actions.

Test one missed-condition scenario before you rely on the reply. Ask what happens if the named approval does not arrive by its stated point: which allocation the factory releases, whether another group stays intact and when a replacement answer will come. This asks for the supplier’s current response rule, not a guaranteed fallback. If the question goes unanswered, treat it as an open risk in your decision.

A calendar icon, clock and unfilled decision marker.
A conditional offer needs a clear expiry and a defined response if its condition remains open.

Can a Knitwear Factory Reply Support a Separate Group?

Test independence across material and later work

A split helps only when the groups can be controlled separately without hiding shared constraints. Ask whether material quantities, lots, special components, finishing, inspection and packing allow the separation. If groups A and B share a material purchase, starting A can still change B’s exposure. If they share a later operation, early knitting may not bring an earlier handover.

Also check that each group still meets the minimum for its colors and sizes, which starts at 50 pcs per color per size with us. Ask for the changed dependencies and dates before you accept the proposal, and do not assume that fewer units take fewer calendar days. The MOQ and lead time page gives the general sequence, while the current reply supplies the actual timing.

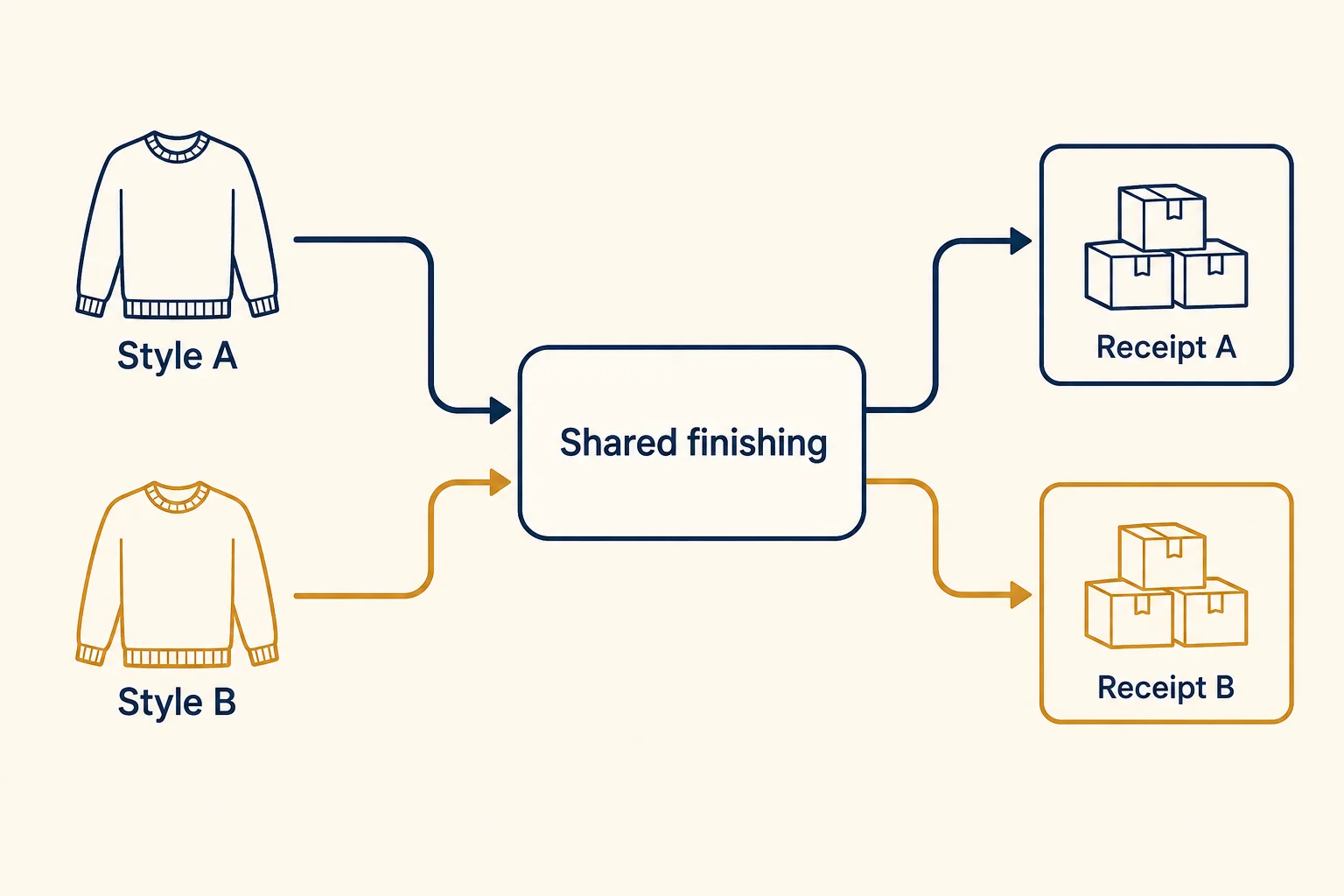

Two style paths in a knitwear factory reply enter a shared finishing node and continue to separate receipt groups.
Separate start groups may still depend on one later operation before their respective receipts.

Keep the product and receiving identity intact

Define which styles, colors, sizes and quantities belong to each group, and keep the product revision and release references attached. A split that loses size coverage, mixes unresolved goods into released cartons or confuses the receiving documents has not solved the problem. Confirm that the destination accepts the proposed receipt pattern before you call it a recovery plan.

A schedule split does not waive product approval. If a group uses a different material lot or process after the split, ask the product owner what comparison is needed. The supplier’s ability to schedule a change and your approval of its product effect are two separate decisions.

What Must a Revised Knitwear Factory Reply Preserve?

Compare the changed scope and commercial basis

When the supplier proposes another route, ask for an old-to-new comparison: affected group, resource, material or process, dates, conditions and commercial effect. Keep the specification fixed unless the supplier expressly proposes a product change. A faster route that changes a defining finish is not the same offer with a better date.

Check the commercial basis against the sweater manufacturing cost guide. Price, extra handling, residual material, inspection and separate receiving work may all need review. Do not assume who pays, and do not present an unagreed cost as a supplier obligation. Until those numbers arrive, you cannot compare the alternatives on equal terms.

In the example, a different finishing route for group C could be investigated, but availability does not prove product equivalence. The right response may stay a hold until the technical and commercial owners have their evidence. Keeping the unsupported original date is not an alternative route.

Do not recover dates by hiding quality or sourcing changes

If the proposal moves work to another site or an outside process, identify the changed party and the review it needs. A new sourcing relationship should stay visible instead of being accepted only because it offers an earlier date.

Keep the agreed product checks inside the revised route. Our quality control page outlines how inspection fits into production. A timetable should include the decision after a finding, not only the inspection date, and unresolved goods stay outside any assumed released quantity.

Close view of navy and gray knitted cardigan fronts with button plackets.
A revised route should not conceal changes to the product, testing basis or responsible production party.

What Decision Should You Send Back After a Knitwear Factory Reply?

Return a bounded acceptance or a precise hold

Write the result by group and reference the current reply. State which scope is supported, which action is authorized, which conditions remain and which earlier proposal is superseded. If no action is authorized yet, say so. A broad message such as “proceed with the order” erases the distinctions the review exists to keep.

In the example, the buyer might accept group A’s defined route subject to release authority, leave B conditional until the sample gate and validity check, and hold C pending another offer. A real response must follow the actual evidence and agreed terms.

Keep the outcome next to the source documents. A useful record has the reply date, scope revision, resource status, condition, expiry, notification owner, receiving event and approved action. It should also list unresolved questions, so nobody mistakes an unanswered field for an unchanged fact.

Recheck on changed evidence, not on reassurance

Name the events that reopen the decision: a missed approval, an expired reservation, a changed material or route, a failed product check, an altered receiving requirement or a revised allocation. Ask for a fresh answer on the affected group only. Do not repeat a full capacity questionnaire just because time has passed.

Finally, compare the supplier’s offer with your own commitment record. Both should describe the same group and conditions. A clean audit table or a confident email does not guarantee delivery. Its value is that the next action has a clear basis, and a new problem can be traced to the decision it changed.

Knitwear Factory Reply FAQ

Is an available slot the same as a reserved slot?

No. Availability describes a current possibility, while a reservation needs an identified scope and applicable terms. Ask what action has actually been taken, how long it applies and what would cause it to change.

Can a sample confirmation support a bulk start date?

Only as one input. The bulk route needs its own current resource and readiness evidence. A sample team being available does not establish material readiness, knitting allocation, finishing availability or release capacity.

What if a reservation expires while I review the reply?

Request a current response instead of assuming the earlier offer survives. Record the missed condition and its effect on the affected group, and review any existing obligations under the agreed terms.

Does a split order always arrive sooner?

No. Shared materials, later processes, release decisions or receiving conditions can prevent a useful separation. Ask for the revised complete route and its commercial effect, because an earlier start for one activity does not prove an earlier usable receipt.

Should every new knitwear factory reply trigger a full audit?

No. Review the affected decision when evidence or a named assumption changes, and keep unchanged confirmations attached to the current record. A focused check is enough when you can say what changed and what remains supported.

If you want a second pair of eyes on a schedule you have received, contact CN Sweaters with the reply and your styles and describe the receiving date you need to meet.
