Most buyers think a sweater order starts when they send a tech pack. From the factory side, however, the work starts earlier, with yarn sourcing, machine programming, and a fixed run of sweater production steps. If one step slips, every step after it moves too.
Knowing that sequence helps you plan sampling, set a realistic delivery date, and catch quality problems while they are still cheap to fix. Below, we walk through all 12 stages in a Chinese knitwear factory. For each one, we note what can go wrong and what you, as the buyer, can check or ask.
This guide is for brand owners, wholesale buyers, and sourcing managers. It applies whether you are placing a first order or reviewing a new supplier.
Why the Order of Sweater Production Steps Matters

Sweater manufacturing is a chain of 12 stages. Each stage needs its own equipment and skilled workers, and most of them hand work directly to the next. So a problem at Step 4 does not only delay Step 4. It delays everything after it.
| Step | Stage | Key Risk or Note |
|---|---|---|
| 1 | Order Confirmation | Incomplete specs pause the entire timeline |
| 2 | Yarn Sourcing & Ordering | Lot mismatch if reorder is needed |
| 3 | Yarn Inspection & Storage | Specialty fibers add 1–2 days |
| 4 | Pattern Engineering & Size Grading | Errors propagate across the full run |
| 5 | Machine Knitting | Gauge determines speed and texture |
| 6 | Overlocking | Prevents unraveling before linking |
| 7 | Linking | Tension control = size consistency |
| 8 | Hand Stitching | Labor-intensive; varies by style |
| 9 | Garment Washing | Controls hand feel and pre-shrinkage |
| 10 | Ironing & Blocking on Templates | Template wear causes measurement drift |
| 11 | Labeling | Compliance risk if spec not finalized early |
| 12 | QC Inspection, Mending & Packing | Light-table needed for dark/fine-gauge |
What Has to Happen Before a Single Panel Gets Knitted
Before a machine knits a single row, the factory needs a confirmed order. That means style (pullover, cardigan, hoodie), quantity, full size run, color references, and an approved pre-production sample (PPS). It also means a delivery date and packing requirements. Without these, yarn cannot be bought correctly and machines cannot be set up.
First-time buyers should note this. Missing or unclear specs at confirmation are a frequent cause of late bulk orders. For example, if the factory is waiting on your color approval or size spec, the lead time clock is not running. It is paused until you reply.
Which Sweater Production Steps Cause Most Delays and Defects
The riskiest stages are not the ones that look the most complex. In our experience, yarn lot inconsistency, pattern engineering errors, and uneven linking tension cause a large share of quality issues and late shipments. These are rarely failures at the knitting machine. Instead, they start in the preparation stages that feed it, so we cover each one below.
Three problems show up most often in bulk: shade variation, measurement drift, and pilling. Shade variation usually traces back to yarn lots. Drift comes from knitting tension, linking, and finishing. Pilling depends on the yarn and the finish. So skip the vague question “Do you inspect quality?” Ask “How do you control color continuity?” or “What happens if measurements drift during bulk?” Specific questions get specific answers.
Sweater Production Steps 1–3: Yarn and Pre-Production

These three steps happen before any machine time is booked. Even so, they set the ceiling for everything that follows. Rushing them rarely saves time, because the problems they create downstream take longer to fix.
Step 1 — Order Confirmation
This is the factory’s formal intake of your brief. A responsible sweater factory will not buy yarn or schedule machines until the order is confirmed with a complete spec sheet and an approved sample. The more complete your brief, the fewer back-and-forth rounds you need. Therefore, include quantity per color per size, special construction details, and packaging requirements from the start.
If you work through an OEM/ODM service, this stage also covers gauge, yarn options, and cost targets. Agree on these before you commit to a direction.
Step 2 — Yarn Sourcing and Ordering
Once the order is confirmed, the factory calculates the total yarn weight needed. Then it orders slightly more than that amount. This buffer is not padding. Knitting defects happen, and if the factory runs short mid-production, a new yarn lot may not match the first one in color or hand feel.
Yarn is also sold by cone or bale weight rather than exact grams, so small overages are normal. A slight surplus is far better than a shortfall that stops the whole run.

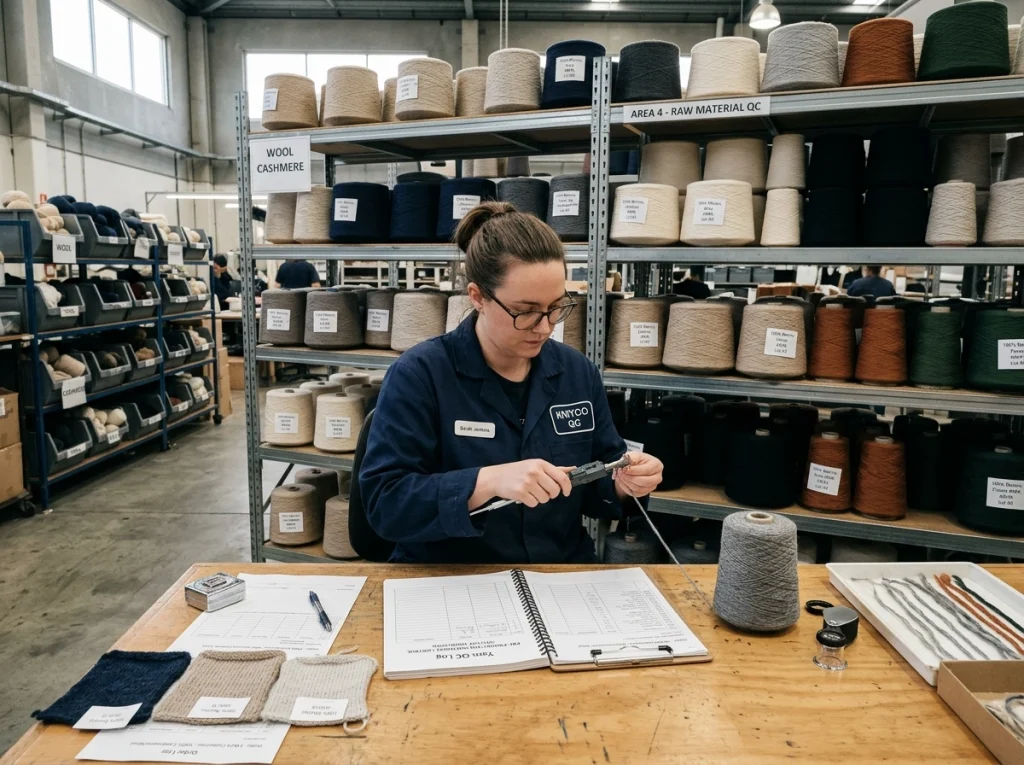

Step 3 — Yarn Inspection and Storage
When yarn arrives, it does not go straight to the machines. First, samples are tested against the order specs for yarn count, color consistency, and evenness. Yarn that fails goes back to the supplier.
This matters to buyers more than it seems. If your order uses a specialty fiber such as merino, recycled polyester, or a cashmere blend, inspection can add one to two days. So ask exactly when the factory’s “production start” date begins. That avoids the common mix-up where the factory and the buyer count lead time from different points.
Steps 4–6: Turning Your Design Into Knitted Panels

These three sweater production steps turn a spec sheet into knitted fabric. Step 4 carries more risk than most buyers expect. Once you understand it, you will review samples differently.
Choosing the Construction Method
Before the program is written, the factory and buyer settle how the sweater is built. Fully fashioned construction shapes each panel on the knitting machine and then links the panels together. Cut-and-sew construction knits fabric first and cuts the pieces afterward. Each route trades off seam appearance, fit control, labor, and cost. So judge the choice by your market and price target, and ask the factory why it recommends one method over the other.

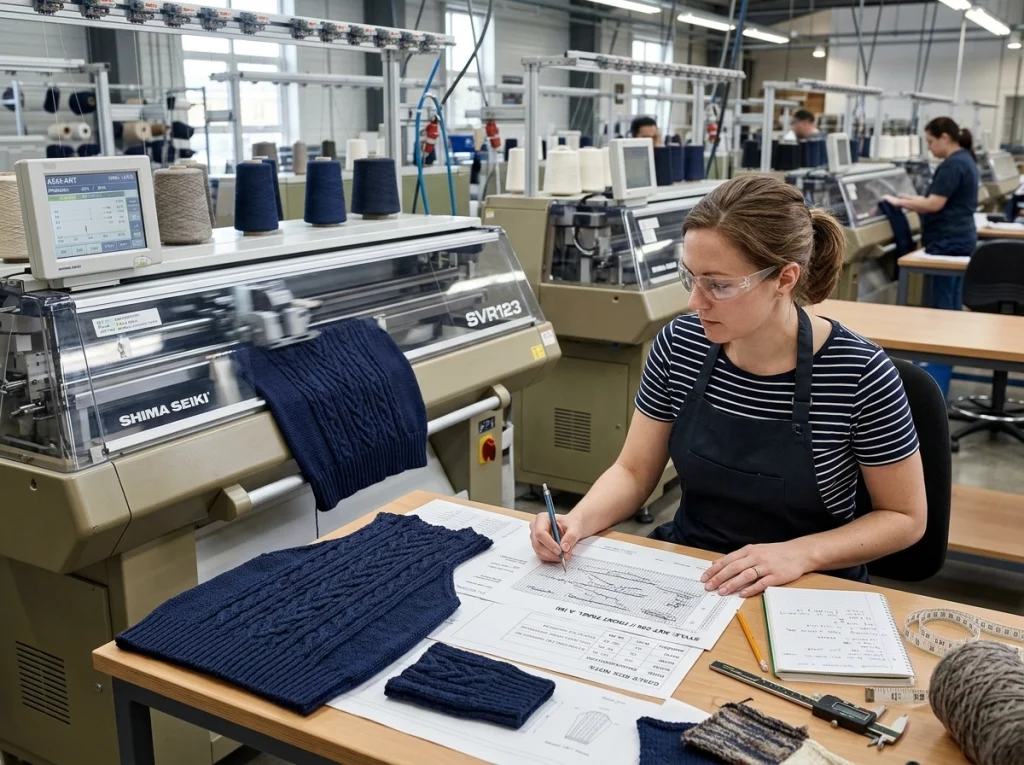

Step 4 — Pattern Engineering and Size Grading
This is the translation layer between your design and the knitting machine. A pattern engineer writes the full production program. It covers knitting sequences, stitch counts, machine gauge settings, and size grades across your size run.
Any mistake here repeats in every unit. For instance, a size grade that was never checked against your fit specs does not produce one bad sweater. Instead, it produces a whole run that needs rework.
For styles that need ODM sweater development, give this stage extra attention during sample review. That includes unusual construction, mixed stitch structures, or custom sizing. Ask the factory to confirm that the program matches your approved sample, including any fit comments. That check is worth an extra day.
Step 5 — Machine Knitting
After the program is loaded, computerized flat knitting machines knit each panel separately. Typical panels are the front, back, sleeves, collar, and plackets. Meanwhile, operators watch tension and stitch density throughout the run. Ask whether the first knitted panel is measured against the approved sample before the bulk run is released.
Gauge is where machine choice becomes a buyer decision. A 7-gauge machine gives a chunky, textured knit, which suits heavier cardigans in thick yarn. In contrast, 14-gauge or finer gives a light, smooth fabric for elevated basics and the finer styles in our sweater range. Higher gauge means more needles per inch. As a result, each panel takes longer to knit, and the same quantity needs more machine time.
Step 6 — Overlocking
Next, the raw edges of each panel are overlocked (serged). This stops unraveling and gives a stable edge for linking. It is a short step, but panels that skip it tend to develop seam defects during assembly. Those defects are hard to fix later.
Sweater Production Steps 7–9: Assembly and Wet Finishing

Here, separate panels become a recognizable garment. These stages also need the most skilled hand labor. That limits factory capacity and, in turn, your realistic lead time in peak season.

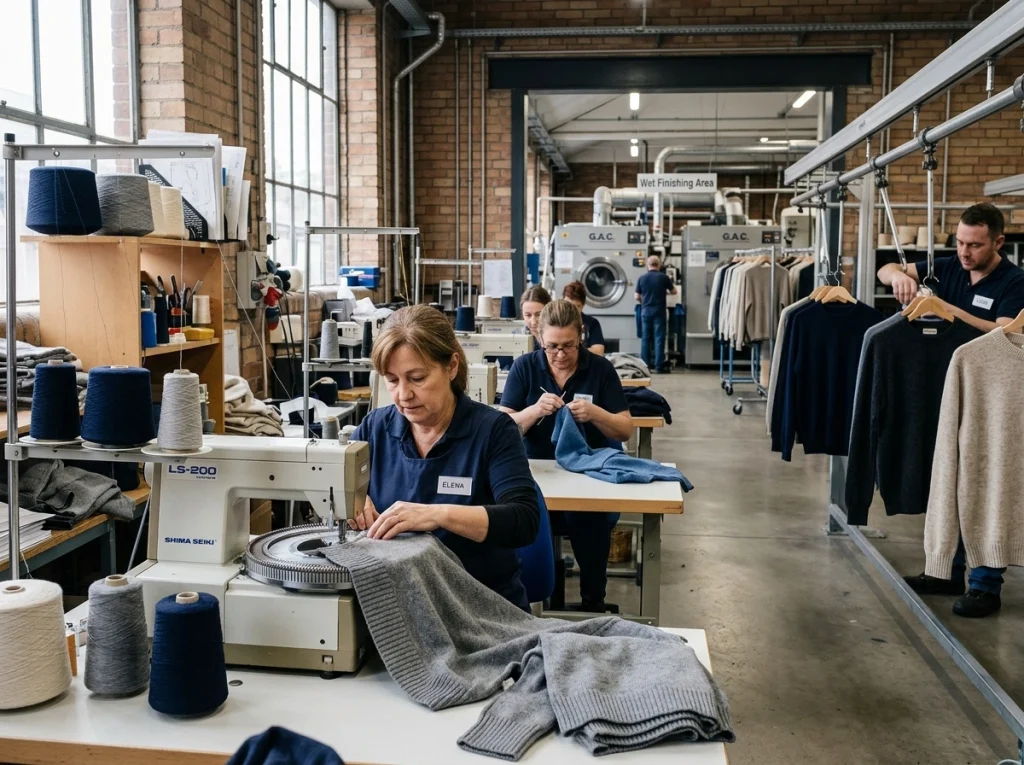

Step 7 — Linking (Seaming the Panels)
Linking joins the panels at the side seams, shoulders, armholes, collar, and sleeves. The operator places each loop onto the linking machine’s needles one by one. Poor linking shows at once, because uneven tension makes the garment pull or twist and shifts its measurements.
Linking tension is a common source of size variation across a bulk run. You can read more on why linking quality matters in a separate guide. Also, during the August–January peak, linking stations are often the bottleneck. If your delivery window is tight, ask about linking capacity before you confirm the timeline.
Step 8 — Hand Stitching
Some areas cannot be closed by machine, such as parts of the collar join, certain cuff finishes, and special closures. Workers finish these by hand. They also remove waste yarn, trim, and pick loose ends before washing.
This step rarely comes up in cost talks, yet it adds real labor time. That is especially true for complex necklines or trims. For example, a zip-front knit hoodie needs more hand work than a plain crew neck. So if your order mixes styles, plan hand-finishing time per style.
Step 9 — Garment Washing
Assembled garments then go through garment washing. This is more than cleaning. Washing removes knitting oils, sets the hand feel and drape, and pre-shrinks the garment. As a result, finished measurements hold after the end customer washes it.
The wash recipe decides how the sweater feels on arrival, yet many buyer briefs leave it out. If bulk ever felt stiffer or softer than your approved sample, the wash formula is the first place to look. Therefore, write the softener or wash type into the spec and keep a washed reference sample. Also approve the sample in its washed, finished state, not its pre-wash look, because bulk will be judged against it.
Steps 10–12: Shaping, Final QC, and Packing

The last three sweater production steps take a washed garment to retail-ready and shipped. Each one affects what you find when you open the cartons in your warehouse.
Step 10 — Ironing and Blocking on Templates
Sweaters are not ironed flat like woven shirts. After washing, knitwear relaxes and loses shape. So each piece goes onto a wooden or metal board cut to the finished measurements, then gets steamed into shape. This is how the chest width and body length on your spec sheet reach your warehouse.
Board accuracy matters when your customers expect tight sizing. If boards are worn or poorly kept over a long run, measurements drift unit by unit. Therefore, ask how often the boards are checked when you audit a new factory. Measurements should also be taken only after garments have cooled and rested, since a reading taken straight from the steam can mislead.
Step 11 — Labeling
Workers then sew in care, size, and neck labels to the buyer’s specs on a flat-bed machine. The step itself is simple, but errors are costly. Wrong placement, missing fiber content or care instructions, or size labels that do not match the cartons can cause problems at customs or in store.
If you ship to the US or EU, finalize and sign off label specs well before bulk starts. When labeling is left until packing, it often causes last-minute delays.
Step 12 — QC Inspection, Mending, and Packaging
Final QC includes light-table inspection. This is important for dark colors such as black, navy, and dark green. It also matters for fine gauges above 14GG, where small holes or dropped stitches are hard to see. Garments that fail go to mending, while pieces that cannot be repaired are rejected.
Our quality control process at this stage also covers measurements against the approved spec sheet. It also includes shade checks under standard light sources (D65, TL84, UV) and stretch checks at hems, necks, and cuffs. Passed garments are then packed to your requirements, such as flat fold or hanging, polybags, and swing tags. Finally, cartons are marked with shipping marks, style, color, size, and carton numbers. Before the cartons close, ask the factory to confirm that measurements, appearance, labels, and packing all match the approved sample, and that the finish matches the one you signed off.
How Sweater Production Steps Shape Lead Time and MOQ

Most of the 12 steps must run in order. You cannot link before you knit, and you cannot wash before you link. That is why sweater lead times are usually longer than for woven garments. It is also why buyers who ignore the sequence often end up in rushed production that hurts quality.
At CN Sweaters, a typical new style follows this timeline:
- Sampling: usually 3–7 days to make the sample, plus courier time to you and your review time.
- Bulk production (Steps 1–12): usually 15–45 days after sample approval. The range depends on gauge, quantity, yarn availability, and season.
- What pushes toward the long end: dyed-to-order yarn, fine gauges, complex hand finishing, and the August–January peak, when linking and finishing capacity is tight.
Our MOQ starts at 50 pieces per color per size. That is enough for a style test or a small seasonal run. Larger quantities let several machines knit the same style at once, so both unit cost and speed improve with scale. Our MOQ and lead time page explains how yarn and style affect these numbers.
For a new style, plan one full sample-and-approval cycle before bulk begins. Trying to squeeze sampling and bulk into the same window is a frequent cause of first-order delays.
Planning Your Order Around the Sweater Production Steps
In practice, buyers who get clean bulk and on-time delivery do three things. First, they send complete specs at order confirmation. Second, they approve wash, measurements, and labels on the sample instead of during bulk. Third, they ask where the factory checks each stage, rather than relying only on a final inspection.
Keep Records So Repeat Orders Follow the Same Sweater Production Steps
A repeat order shows whether a factory controls its process or only remembers it. If the first run looked right because one technician recalled the details, the second run may drift. So ask the factory to archive yarn lots, color references, the approved sample standard, size comments, wash notes, and label and carton references. Our guide to keeping bulk consistent from sample to release shows how those records are used.
For a quick check at each phase, buyers can ask about:
- Yarn planning: lot continuity and whether replenishment is feasible.
- Sampling: fit, stitch feasibility, and the washed result.
- Knitting: panel quality and how defects are handled.
- Linking and finishing: seams, loose ends, final hand feel, and measurements.
- Packing: labels, carton ratio, and the packing list.
If you want a production-level view of the process, Cotton Incorporated’s CottonWorks site has a useful overview of sweater manufacturing basics. When you are ready to plan a new knitwear line, CN Sweaters can review it with you. Send your tech pack, target price, and delivery window, and we will tell you plainly what is achievable.
FAQ: Sweater Production Steps
Q: How long do the sweater production steps take from yarn to shipment?
The sample usually takes 3–7 days, plus courier and review time. Bulk then usually takes 15–45 days after sample approval. So for a new style, plan roughly four to ten weeks from tech pack to cartons ready, with extra buffer in peak season.
Q: What is the MOQ for a sweater order at CN Sweaters?
Our MOQ starts at 50 pieces per color per size, which suits a seasonal trial. However, complex styles, specialty fibers, or yarn dyed to order may need higher quantities, so confirm MOQ per style.
Q: Why do sweater samples take longer and cost more than woven samples?
A sweater sample follows the same sequence as bulk. It needs the same programming, knitting, linking, hand finishing, and washing. There is no shortcut for one or two pieces. In bulk, the setup cost spreads over hundreds of units, while in sampling it falls on one garment.
Q: What causes measurement inconsistency across a bulk run?
The three usual sources are grading errors in the program (Step 4), uneven linking tension (Step 7), and worn boards during blocking (Step 10). Measurement checks at several stages are the main control. So if bulk keeps arriving out of tolerance, ask which QC checkpoints are active and how often they run.
Q: When is the best time to place a sweater order with a Chinese factory?
February through July is the off-season for most Chinese knitwear factories, so capacity is easier to book and lead times are more predictable. From August through January, capacity fills quickly. For fall/winter or holiday collections, ordering before September gives you the most flexibility on price and timing.
